The Challenge of Upgrading Aging Systems in Occupied Buildings
Your aging multi-zone commercial rooftop units are failing, but shutting down the building during the workweek simply isn't an option. Phasing a Commercial HVAC Retrofit Without Disrupting Portage Office Tenants requires a level of logistical precision that goes far beyond standard equipment replacement. Property managers are constantly caught between the urgent need to upgrade failing infrastructure and the absolute necessity of keeping their commercial tenants comfortable and operational from Monday through Friday.
Upgrading a massive commercial building is a complex undertaking. If you need to replace your entire commercial HVAC system, you are looking at coordinating heavy crane lifts, managing structural transitions, and executing intricate ductwork modifications. Transitioning to modern rooftop package units often means dealing with entirely new equipment footprints, heavier chassis designs, and updated electrical requirements that must be handled with extreme care.
To solve this, our commercial team at Adams Heating & Cooling utilizes a highly strategic project management approach that guarantees zero operational downtime for commercial tenants. Across various Portage commercial office parks, we have refined our methodology over years of serving the greater Kalamazoo area, managing these complex logistical cutovers over a single, tightly orchestrated weekend. We understand firsthand that a successful retrofit is not just about technical HVAC skills; it is about aggressive, proactive project management.
The core challenges of occupied-building retrofits we navigate include:
• Tenant productivity: Weekday disruptions lead to lost revenue for your tenants and potential lease violations for property managers.
• Safety protocols: Heavy equipment rigging and crane lifts cannot safely occur while parking lots are full of employee vehicles and pedestrian traffic.
• Structural complexities: Older building roofs require specific load assessments before they can accept the weight and vibration of modern, high-efficiency equipment.
• Environmental compliance: Safely recovering old refrigerants and disposing of massive industrial components requires specialized handling that cannot interrupt daily business operations.
Capitalizing on the September Shoulder Season
Waiting for a total system failure in the dead of winter is a catastrophic strategy for commercial tenant retention and overall building safety. If a massive rooftop unit fails in January, your tenants are left freezing, and emergency replacements are severely complicated by ice, snow, and dangerous roof conditions. Southwest Michigan is notorious for its extreme seasonal shifts, moving rapidly from lingering late-summer humidity directly into bitter, freezing winds.
That is exactly why Adams Heating & Cooling targets the September pre-heating season transition for major commercial retrofits. This brief weather window provides the ideal conditions for a massive weekend cutover. The temperatures are generally mild enough that taking the building's HVAC offline for 48 hours will not expose the interior to extreme heat or freezing cold. The building retains its ambient temperature comfortably while our crews work overhead.
Furthermore, completing this proactive replacement during the fall shoulder season significantly reduces building energy consumption right before your peak usage months. Modern units operate with vastly superior efficiency, meaning your winter heating bills will reflect the upgrade immediately. Upgrading to qualifying high-efficiency systems may also make your property eligible for various federal tax credits or local utility incentive programs (we advise checking with a tax professional or your utility provider to verify current programs).
• Tenant Comfort — Reactive Winter Replacement: Severe disruption; immediate exposure to freezing temperatures indoors. — Proactive September Retrofit: Zero disruption; mild ambient temperatures maintain indoor comfort while offline.
• Safety Risks — Reactive Winter Replacement: High risk due to icy roofs, snow loads, and poor visibility for crane operators. — Proactive September Retrofit: Low risk; clear weather and dry roofs allow for safe, rapid rigging and lifting.
• Energy Costs — Reactive Winter Replacement: Missed savings during the first half of winter; potential emergency heating costs. — Proactive September Retrofit: Immediate reduction in energy consumption ahead of peak winter heating demand.
• Project Timeline — Reactive Winter Replacement: Delayed by weather, emergency permitting, and frozen structural components. — Proactive September Retrofit: Controlled, predictable 48-hour weekend window executed with precision.
Pre-Installation Logistics and Structural Preparation
The physical weekend cutover is just the final act of a process that begins weeks in advance. Thorough behind-the-scenes planning is the only way to guarantee a seamless transition. At Adams Heating & Cooling, we begin with a comprehensive initial site assessment at your facility. Within Portage commercial office parks, building codes and structural load requirements are strict, and our team verifies every detail long before a crane is scheduled.
A critical step in this early phase involves evaluating structural load for new rooftop HVAC units. Modern, high-efficiency systems often feature larger condenser coils and heavier internal components than the 20-year-old units they replace. We must verify the existing roof footprint and ensure the structural steel below can safely support the upgraded equipment without bowing or transferring excess vibration into the office spaces below.
Simultaneously, we measure and pre-order custom curb adapters. Because a new unit rarely matches the exact dimensions of an old one, these adapters are vital for a fast installation. We also manage the complex coordination required for acquiring crane permits, securing local municipal approvals, and scheduling heavy equipment in busy commercial zones. Parking lots must be barricaded, and staging areas must be cleared of civilian vehicles.
Our pre-installation checklist includes:
• Electrical capacity verification: Ensuring the building's main breakers and disconnects can handle the starting amps of the new motors.
• Gas line sizing: Confirming that existing gas manifolds deliver the correct water column pressure for the new heating sections.
• Logistical staging: Mapping out the exact swing radius for the crane to avoid power lines, trees, and neighboring structures.
• Safety planning: Establishing clear communication protocols between the ground rigging crew and the roof technicians.

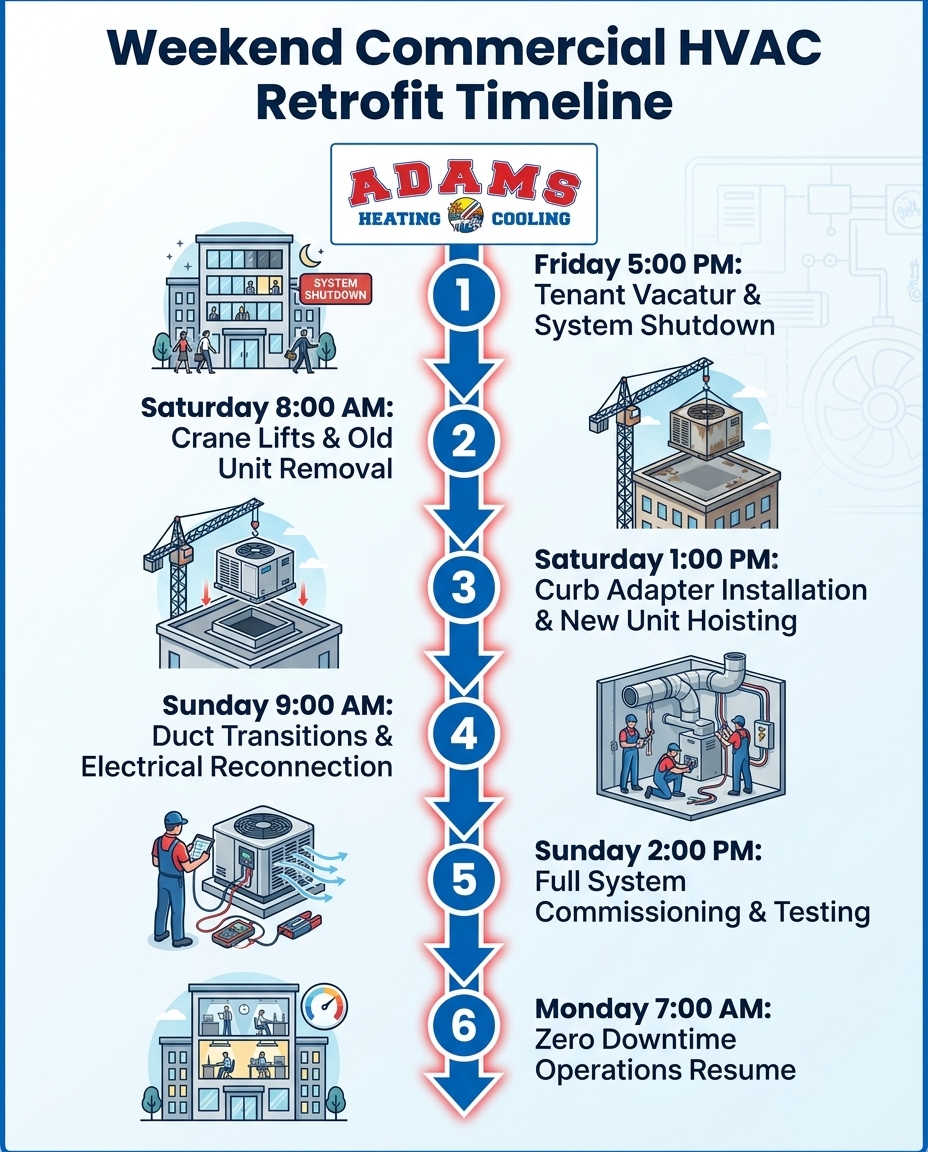

Friday Evening: Initiating the System Shutdown
The execution phase begins the moment the workweek ends. As office tenants log off and vacate the building at 5:00 PM on Friday, the Adams Heating & Cooling logistical timeline officially kicks off. Executing this timeline requires a team equipped for true 247 commercial hvac services portage, allowing our technicians to work seamlessly and safely through Friday night to prepare the site for Saturday's heavy lifting. Our team strictly handles the following specialized phases:
• Securing the perimeter: Ground crews immediately establish safety barricades around the designated crane staging area in the parking lot, ensuring complete safety for any remaining after-hours cleaning staff or security personnel.
• Electrical and gas disconnection: Our licensed technicians safely disconnect all high-voltage power lines, natural gas piping, and low-voltage control wiring from the old multi-zone rooftop units (RTUs). Every line is capped, locked out, and tagged out according to OSHA regulations.
• Refrigerant recovery: We deploy specialized recovery machines to carefully extract the existing refrigerants from the aging system. This process strictly adheres to EPA guidelines and local environmental regulations, ensuring zero harmful chemicals are vented into the atmosphere.
• Hardware unsealing: The roof crew removes decades-old fasteners, cuts away degraded weather sealant, and unseals the primary ductwork connections, completely freeing the physical unit from the building structure so it is ready for immediate lifting at dawn.

Saturday Execution: Crane Lifts and Curb Adapters
Saturday morning is dedicated to heavy lifting, precision rigging, and physical installation. By 8:00 AM, the crane is fully positioned, stabilized, and ready to work. Our rigging crew attaches heavy-duty straps to the old multi-zone rooftop units (RTUs), carefully finding the center of gravity. With clear communication between the roof team and the crane operator, the old units are hoisted off the building and safely lowered onto flatbed trucks for recycling and disposal.
Once the old units are out of the way, the roof footprint is exposed. The team quickly cleans the existing roof curb, removing old gasket material and debris. This is the moment where weeks of precise pre-planning pay off, as we prepare to set the new equipment.
The Role of Curb Adapters in Rapid Cutovers
For property managers unfamiliar with the term, a curb adapter is a custom-fabricated, heavy-gauge metal transition piece. It acts as a structural bridge between the existing roof opening (the old footprint) and the bottom chassis of the modern, energy-efficient RTU being installed. Because manufacturers constantly update their equipment dimensions to accommodate larger, more efficient coils, new units almost never fit perfectly onto old roof curbs.
In our years of managing commercial HVAC in Kalamazoo and Portage, we've found that without a pre-ordered curb adapter, you would be forced to cut into the roof deck, re-frame the structural steel supports, and hire a commercial roofing crew to reseal the membrane—a process that takes days and makes a weekend cutover impossible. By utilizing precisely measured curb adapters, we save hours of structural modification time. The adapter drops perfectly onto the old curb, and the new unit drops perfectly onto the adapter, creating a flawless, weather-tight seal in a fraction of the time.
With the adapters securely fastened and sealed with heavy-duty mastic, the crane hoists the new units into the sky. The roof crew guides them gently into place. By late Saturday afternoon, the heavy equipment is gone, the new units are mechanically secured to the roof, and our commercial installation team begins the initial electrical and gas line reconnections.
Sunday Commissioning and Duct Transitions
Sunday shifts the focus from heavy construction to precision engineering and system verification. The new multi-zone rooftop units (RTUs) are physically anchored, but they must now be flawlessly integrated into the building's internal airflow network. The morning is spent completing the final ductwork transitions, applying commercial-grade sealants to ensure zero air leakage, and finalizing the high-voltage electrical terminations.
Once the physical connections are verified, our rigorous system commissioning phase begins. This is not a simple flip of a switch. We meticulously test the static pressure and airflow across all zones to ensure the furthest offices receive the same comfort as those directly beneath the unit. We calibrate the building's smart thermostats, verify that the multi-zone temperature controls are communicating correctly with the new motorized dampers, and check the refrigerant charge under actual operating conditions.
Our commitment at Adams Heating & Cooling to delivering reliable 247 commercial hvac installation portage means we do not stop until every sensor is calibrated and every safety limit switch is tested. We also fire up the commercial heating components, running the gas furnaces through multiple cycles to ensure the system is fully prepared to handle the upcoming winter load safely and efficiently.
Ensuring Long-Term Reliability for Office Tenants
By the time the sun rises on Monday morning, the transformation is complete. Office tenants in Portage commercial office parks arrive at their desks to a fully functioning, upgraded building environment, entirely unaware of the massive industrial operation that took place overhead just 48 hours prior. Our weekend methodology guarantees zero disruptions to their workflow, protecting your rental revenue and your reputation as a proactive property manager.
However, the handover is just the beginning of the system's lifecycle. Following the installation, we focus on post-installation baseline data tracking. We monitor the system's energy consumption during its first few weeks of operation to ensure it is hitting the Department of Energy efficiency guidelines we projected during the planning phase. Tracking this baseline data proves the return on investment for your capital expenditure.
To protect that massive capital investment and maintain the manufacturer's warranty, routine check-ups are absolutely essential. Commercial systems run hard, and regular filter changes, belt tensions, and coil cleanings keep them operating at peak efficiency. We strongly recommend enrolling the property in a comprehensive HVAC maintenance plan to lock in that reliability for the next two decades.
Frequently Asked Questions About Commercial HVAC Retrofits
How do contractors replace commercial rooftop units without disrupting tenants?
At Adams Heating & Cooling, we prevent disruption by utilizing a strict weekend phasing methodology. The process begins at 5:00 PM on Friday when the building empties, allowing our team to safely disconnect systems, utilize cranes on Saturday, and finish commissioning by Sunday evening. This ensures the building is fully operational before Monday morning.
What is the timeline for a commercial HVAC retrofit?
The physical installation takes roughly 48 hours over a weekend, but the planning phase starts weeks earlier. Pre-installation logistics—like structural load assessments, ordering custom curb adapters, and securing crane permits—take several weeks to finalize before the weekend cutover can occur.
Why replace commercial HVAC units in the fall?
The fall shoulder season provides mild ambient temperatures, meaning the building won't freeze or overheat while the HVAC is offline for 48 hours. Replacing aging units in September also ensures your new, highly efficient heating system is ready before the harsh winter weather arrives.
What is a curb adapter in commercial HVAC?
A curb adapter is a custom metal transition frame that allows a new rooftop unit to fit onto an old roof opening. Because modern units have different dimensions than older models, the adapter bridges the gap, saving contractors from having to cut into the roof and rebuild structural supports.
How long does it take to replace a commercial HVAC unit?
With proper pre-planning and custom curb adapters ready, the actual removal of the old unit and setting of the new unit takes just a few hours via crane. The remainder of the weekend is spent on electrical connections, duct transitions, and rigorous system testing.
Can you replace an RTU over the weekend in Portage, MI?
Yes, weekend RTU replacements are our standard protocol for occupied commercial buildings. By coordinating crane logistics, safety barricades, and specialized installation teams, we execute full multi-zone unit replacements between Friday evening and Sunday afternoon.
